SIC 29, details of service concession arrangements

San Miguel Corporation – Annual report – 31 December 2017

Industry: conglomerate

  1. Significant Agreements and Lease Commitments (extract)

Infrastructure

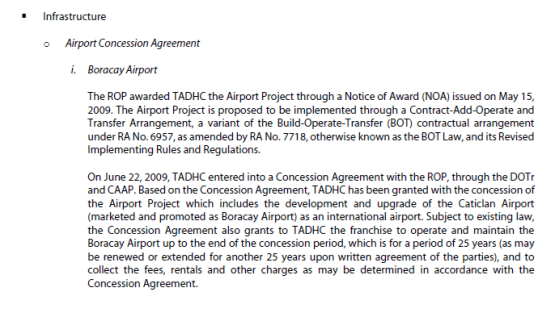

  • Airport Concession Agreement

The ROP awarded TADHC the Airport Project through a Notice of Award (NOA) issued on May 15, 2009. The Airport Project is proposed to be implemented through a Contract-Add-Operate and Transfer Arrangement, a variant of the Build-Operate-Transfer (BOT) contractual arrangement under RA No. 6957, as amended by RA No. 7718, otherwise known as the BOT Law, and its Revised Implementing Rules and Regulations.

On June 22, 2009, TADHC entered into a Concession Agreement with the ROP, through the DOTr and Civil Aviation Authority of the Philippines. Based on the Concession Agreement, TADHC has been granted with the concession of the Airport Project which includes the development and upgrade of the Caticlan Airport (marketed and promoted as Boracay Airport) as an international airport. Subject to existing law, the Concession Agreement also grants to TADHC the franchise to operate and maintain the Boracay Airport up to the end of the concession period, which is for a period of 25 years (as may be renewed or extended for another 25 years upon written agreement of the parties), and to collect the fees, rentals and other charges as may be determined in accordance with the Concession Agreement.

The salient features of the Concession Agreement are presented below:

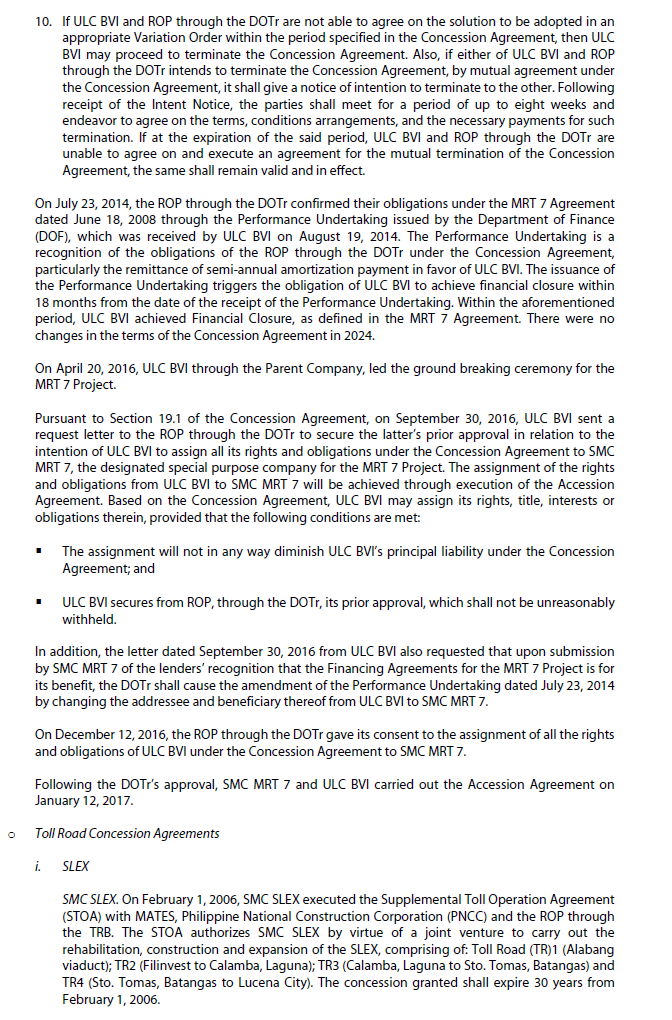

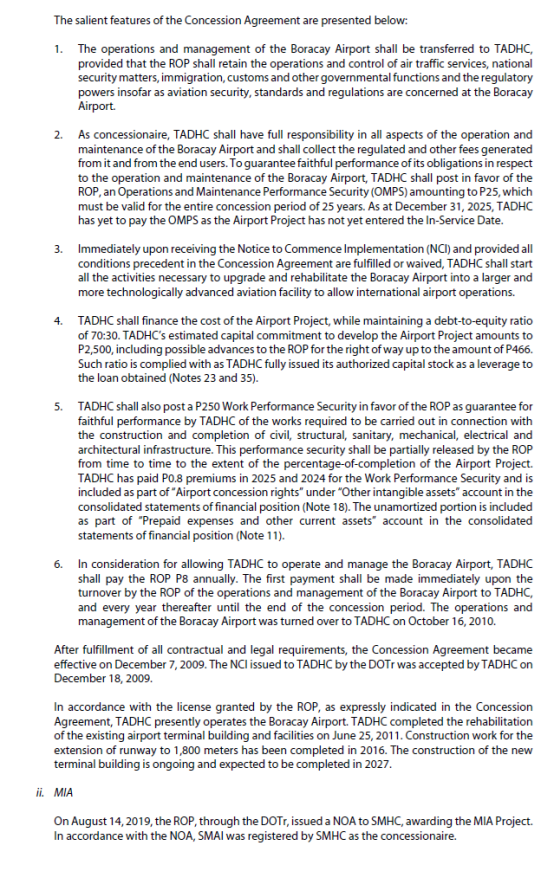

  1. The operations and management of the Boracay Airport shall be transferred to TADHC, provided that the ROP shall retain the operations and control of air traffic services, national security matters, immigration, customs and other governmental functions and the regulatory powers insofar as aviation security, standards and regulations are concerned at the Boracay Airport.
  2. As concessionaire, TADHC shall have full responsibility in all aspect of the operation and maintenance of the Boracay Airport and shall collect the regulated and other fees generated from it and from the end users. To guarantee faithful performance of its obligation in respect to the operation and maintenance of the Boracay Airport, TADHC shall post in favor of the ROP, an Operations and Maintenance Performance Security (OMPS) amounting to P25, which must be valid for the entire concession period of 25 years. As of December 31, 2017, TADHC has yet to pay the OMPS as the Airport Project has not yet entered the In-Service Date.
  3. Immediately upon receiving the Notice to Commence Implementation (NCI) and provided all conditions precedent in the Concession Agreement are fulfilled or waived, TADHC shall start all the activities necessary to upgrade and rehabilitate the Boracay Airport into a larger and more technologically advanced aviation facility to allow international airport operations.
  4. TADHC shall finance the cost of the Airport Project, while maintaining a debt-to-equity ratio of 70:30, with debt pertaining to a loan with BOC. TADHC’s estimated capital commitment to develop the Airport Project amounts to P2,500, including possible advances to the ROP for the right of way up to the amount of P466. Such ratio is complied with as TADHC fully issued its authorized capital stock as a leverage to the loan obtained (Notes 21 and 33).
  5. TADHC shall also post a P250 Work Performance Security in favor of the ROP as guarantee for faithful performance by TADHC of the works required to be carried out in connection with the construction and completion of civil, structural, sanitary, mechanical, electrical and architectural infrastructure. This performance security shall be partially released by the ROP from time to time to the extent of the percentage-of-completion of the Airport Project. TADHC has paid P1 premium in 2017, for the Work Performance Security. The unamortized portion is included as part of “Prepaid expenses and other current assets” account in the consolidated statements of financial position (Note 11).
  6. In consideration for allowing TADHC to operate and manage the Boracay Airport, TADHC shall pay the ROP P8 annually. The first payment shall be made immediately upon the turnover by the ROP of the operations and management of the Boracay Airport to TADHC, and every year thereafter until the end of the concession period. The operations and management of the Boracay Airport was turned over to TADHC on October 16, 2010.

After fulfillment of all contractual and legal requirements, the Concession Agreement became effective on December 7, 2009. The NCI issued to TADHC by the DOTr was accepted by TADHC on December 18, 2009.

In accordance with the license granted by the ROP, as expressly indicated in the Concession Agreement, TADHC presently operates the Boracay Airport. TADHC completed the rehabilitation of the existing airport terminal building and facilities on June 25, 2011. Construction work for the extension of runway has been completed in 2016. The construction of the new terminal is currently ongoing and is expected to be completed in the first quarter of 2019.

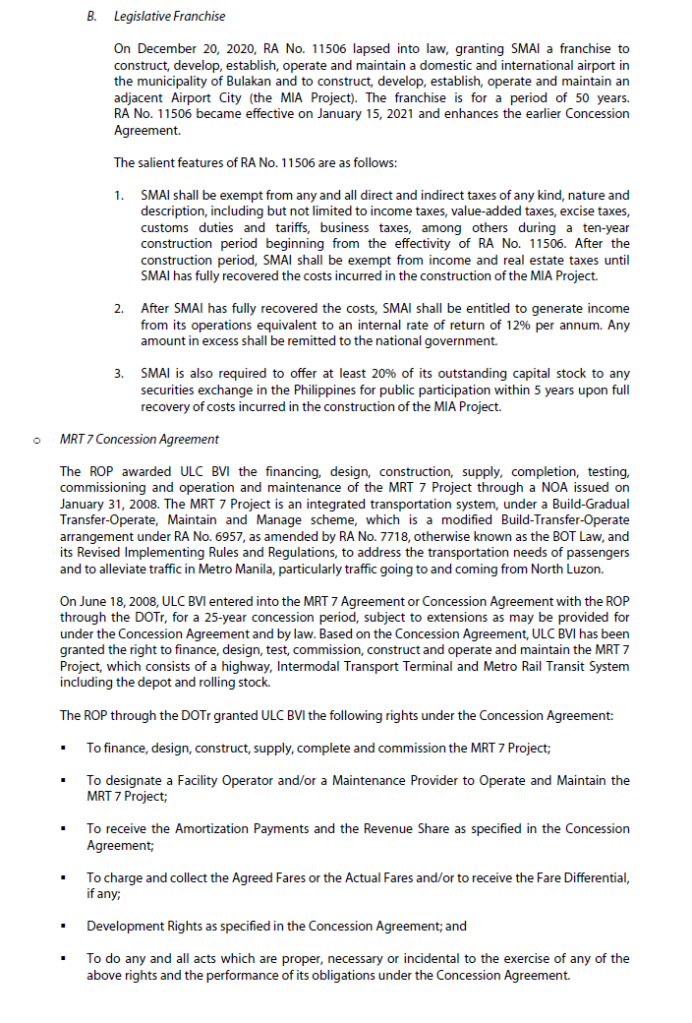

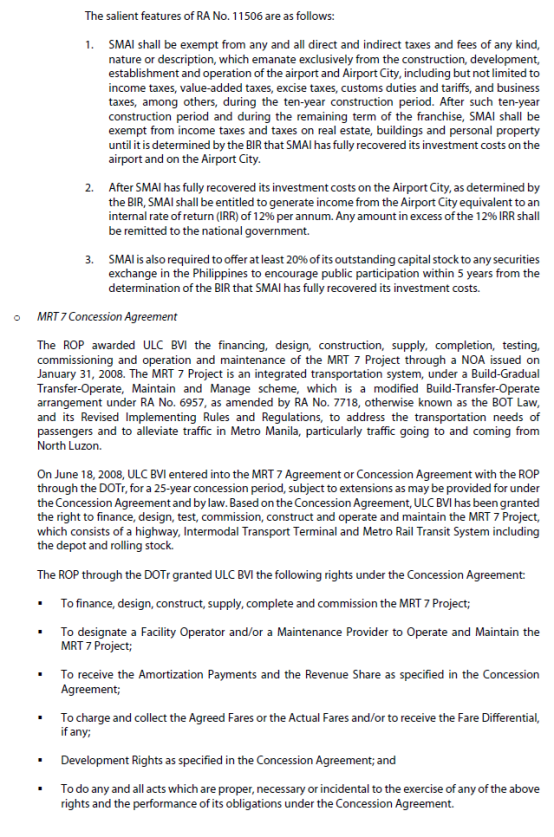

  • MRT 7 Concession Agreement

The ROP awarded ULC BVI the financing, design, construction, supply, completion, testing, commissioning and operation and maintenance of the MRT 7 Project through a NOA issued on January 31, 2008. The MRT 7 Project is an integrated transportation arrangement under RA No. 6957, as amended by RA No. 7718, otherwise known as the BOT Law, and its Revised Implementing Rules and Regulations, to address the transportation needs of passengers and to alleviate traffic in Metro Manila, particularly traffic going to and coming from North Luzon.

On June 18, 2008, ULC BVI entered into the MRT 7 Agreement or Concession Agreement with the ROP through the DOTr, for a 25-year concession period, subject to extensions as may be provided for under the Concession Agreement and by law. Based on the Concession Agreement, ULC BVI has been granted the right to finance, design, test, commission, construct and operate and maintain the MRT 7 Project, which consists of a highway, Intermodal Transport Terminal and Metro Rail Transit System including the depot and rolling stock.

The ROP through the DOTr granted ULC BVI the following rights under the Concession Agreement:

  • To finance, design, construct, supply, complete and commission the MRT 7 Project;
  • To designate a Facility Operator and/or a Maintenance Provider to Operate and Maintain the MRT 7 Project;
  • To receive the Amortization Payments and the Revenue Share as specified in the Concession Agreement;
  • To charge and collect the Agreed Fares or the Actual Fares and/or to receive the Fare Differential, if any;
  • Development Rights as specified in the Concession Agreement; and
  • To do any and all acts which are proper, necessary or incidental to the exercise of any of the above rights and the performance of its obligations under the Concession Agreement.

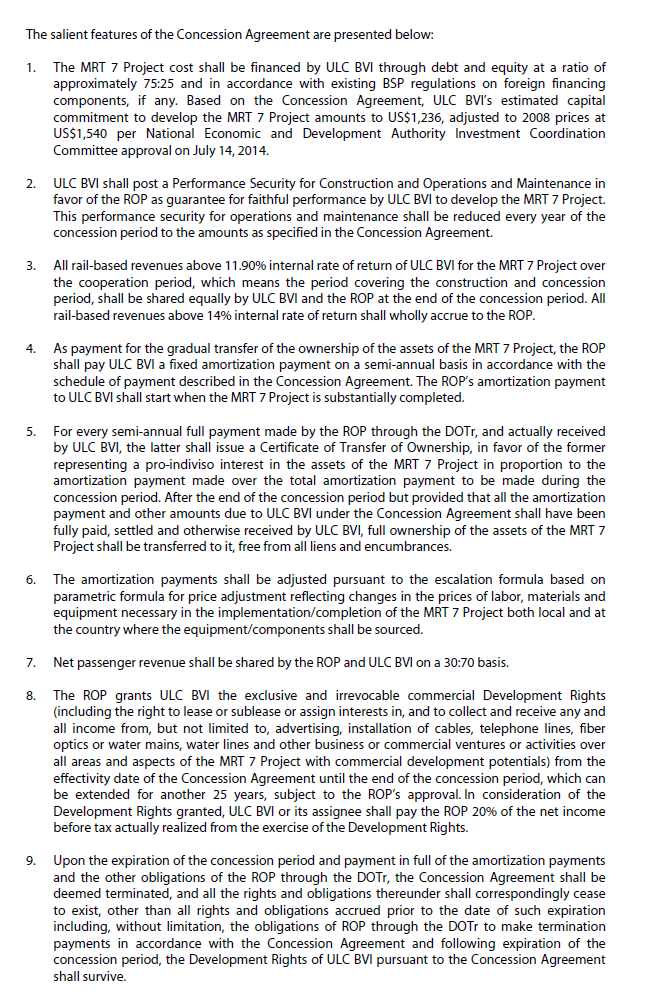

The salient features of the Concession Agreement are presented below:

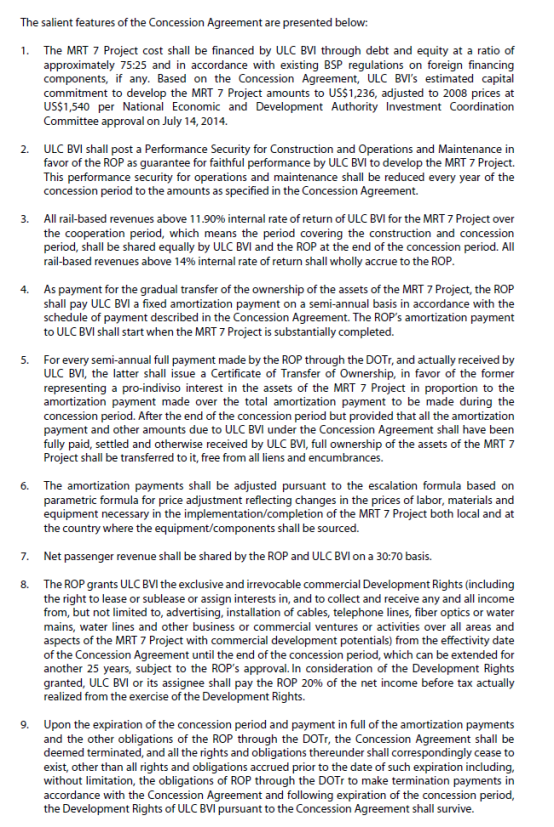

  1. The MRT 7 Project cost shall be financed by ULC BVI through debt and equity at a ratio of approximately 75:25 and in accordance with existing BSP regulations on foreign financing components, if any. Based on the Concession Agreement, ULC BVI’s estimated capital commitment to develop the MRT 7 Project amounts to US$1,236, adjusted to 2008 prices at US$1,540 per National Economic and Development Authority Investment Coordination Committee approval on July 14, 2014.
  2. ULC BVI shall post a Performance Security for Construction and Operations and Maintenance in favor of the ROP as guarantee for faithful performance by ULC BVI to develop the MRT 7 Project. This performance security for operations and maintenance shall be reduced every year of the concession period to the amounts as specified in the Concession Agreement.
  3. All rail-based revenues above 11.90% internal rate of return of ULC BVI for the MRT 7 Project over the cooperation period, which means the period covering the construction and concession period, shall be shared equally by ULC BVI and the ROP at the end of the concession period. All rail-based revenues above 14% internal rate of return shall wholly accrue to the ROP.
  4. As payment for the gradual transfer of the ownership of the assets of the MRT 7 Project, the ROP shall pay ULC BVI a fixed amortization payment on a semi-annual basis in accordance with the schedule of payment described in the Concession Agreement. The ROP’s amortization payment to ULC BVI shall start when the MRT 7 Project is substantially completed.
  5. For every semi-annual full payment made by the ROP through the DOTr, and actually received by ULC BVI, the latter shall issue a Certificate of Transfer of Ownership, in favor of the former representing a pro-indiviso interest in the assets of the MRT 7 Project in proportion to the Amortization Payment made over the total Amortization Payment to be made during the concession period. After the end of the concession period but provided that all the Amortization Payment and other amounts due to ULC BVI under the Concession Agreement shall have been fully paid, settled and otherwise received by ULC BVI, full ownership of the assets of the MRT 7 Project shall be transferred to it, free from all liens and encumbrances.
  6. The Amortization Payments shall be adjusted pursuant to the escalation formula based on parametric formula for price adjustment reflecting changes in the prices of labor, materials and equipment necessary in the implementation/completion of the MRT 7 Project both local and at the country where the equipment/components shall be sourced.
  7. Net passenger revenue shall be shared by the ROP and ULC BVI on a 30:70 basis.
  8. The ROP grants ULC BVI the exclusive and irrevocable commercial Development Rights (including the right to lease or sublease or assign interests in, and to collect and receive any and all income from, but not limited to, advertising, installation of cables, telephone lines, fiber optics or water mains, water lines and other business or commercial ventures or activities over all areas and aspects of the MRT 7 Project with commercial development potentials) from the effectivity date of the Concession Agreement until the end of the concession period, which can be extended for another 25 years, subject to the ROP’s approval. In consideration of the Development Rights granted, ULC BVI or its assignee shall pay the ROP 20% of the net income before tax actually realized from the exercise of the Development Rights.
  9. Upon the expiration of the concession period and payment in full of the Amortization Payments and the other obligations of the ROP through the DOTr, the Concession Agreement shall be deemed terminated, and all the rights and obligations thereunder shall correspondingly cease to exist, other than all rights and obligations accrued prior to the date of such expiration including, without limitation, the obligations of ROP through the DOTr to make termination payments in accordance with the Concession Agreement and following expiration of the concession period, the Development Rights of ULC BVI pursuant to the Concession Agreement shall survive.

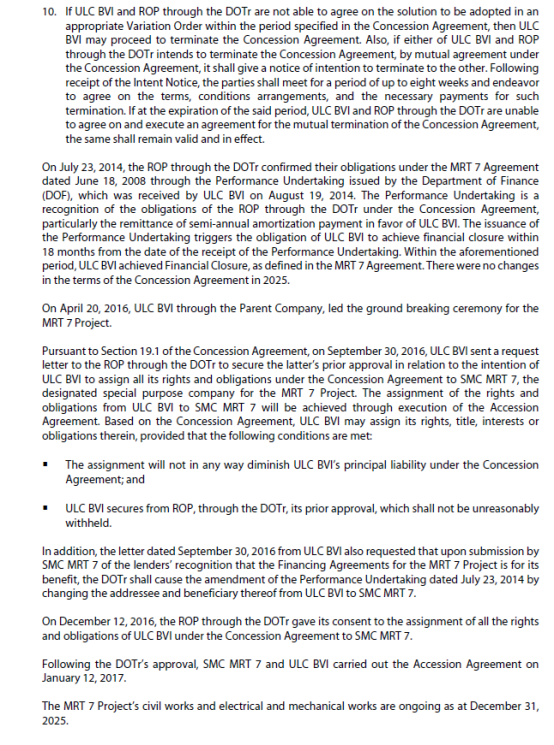

  10. If ULC BVI and ROP through the DOTr are not able to agree on the solution to be adopted in an appropriate Variation Order within the period specified in the Concession Agreement, then ULC BVI may proceed to terminate the Concession Agreement. Also, if either of ULC BVI and ROP through the DOTr intends to terminate the Concession Agreement, by mutual agreement under the Concession Agreement, it shall give a notice of intention to terminate to the other. Following receipt of the Intent Notice, the Parties shall meet for a period of up to eight weeks and endeavor to agree on the terms, conditions arrangements, and the necessary payments for such termination. If at the expiration of the said period, ULC BVI and ROP through the DOTr are unable to agree on and execute an agreement for the mutual termination of the Concession Agreement, the same shall remain valid and in effect.

On July 23, 2014, the ROP through the DOTr confirmed their obligations under the MRT 7 Agreement dated June 18, 2008 through the Performance Undertaking issued by the Department of Finance, which was received by ULC BVI on August 19, 2014. The Performance Undertaking is a recognition of the obligations of the ROP through the DOTr under the Concession Agreement, particularly the remittance of semi-annual amortization payment in favor of ULC BVI. The issuance of the Performance Undertaking triggers the obligation of ULC BVI to achieve financial closure within 18 months from the date of the receipt of the Performance Undertaking. Within the aforementioned period, ULC BVI achieved Financial Closure, as defined in the MRT 7 Agreement. There were no changes in the terms of the Concession Agreement.

On April 20, 2016, ULC BVI through the Parent Company, led the ground breaking ceremony for the MRT 7 Project.

Pursuant to Section 19.1 of the Concession Agreement, on September 30, 2016, ULC BVI sent a request letter to the ROP through the DOTr to secure the latter’s prior approval in relation to the intention of ULC BVI to assign all its rights and obligations under the Concession Agreement to SMC MRT 7, the designated special purpose company for the MRT 7 Project. The assignment of the rights and obligations from ULC BVI to SMC MRT 7 will be achieved through execution of Accession Agreement. Based on the Concession Agreement, ULC BVI may assign its rights, title, interests or obligations therein, provided that the following conditions are met:

  • The assignment will not in any way diminish ULC BVI’s principal liability under the Concession Agreement; and
  • ULC BVI secures from ROP, through the DOTr, its prior approval, which shall not be unreasonably withheld.

In addition, the letter dated September 30, 2016 from ULC BVI also requested that upon submission by SMC MRT 7 of the Lenders’ recognition that the Financing Agreements for the MRT 7 Project is for its benefit, the DOTr shall cause the amendment of the Performance Undertaking dated July 23, 2014 by changing the addressee and beneficiary thereof from ULC BVI to SMC MRT 7.

On December 12, 2016, the ROP through the DOTr gave its consent to the assignment of all the rights and obligations of ULC BVI under the Concession Agreement to SMC MRT 7.

Following the DOTr’s approval, SMC MRT 7 and ULC BVI carried out the Accession Agreement on January 12, 2017.

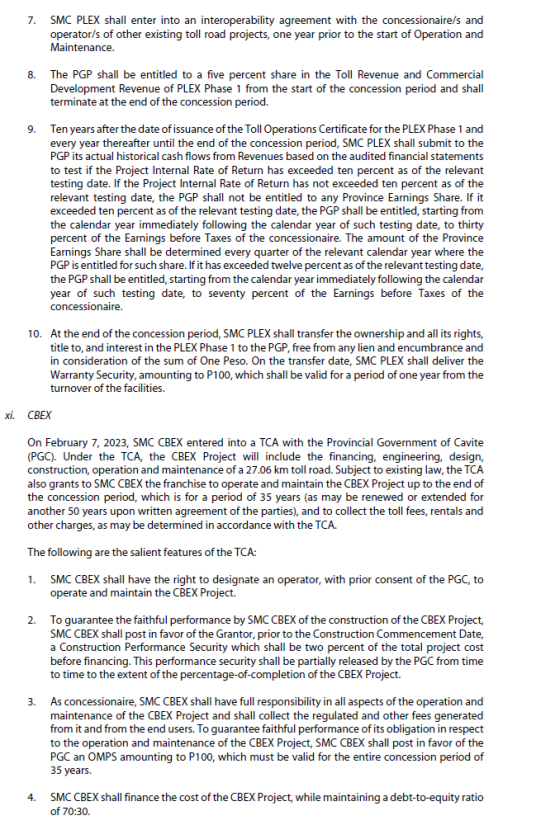

  • Toll Road Concession Agreements

i. SLEX

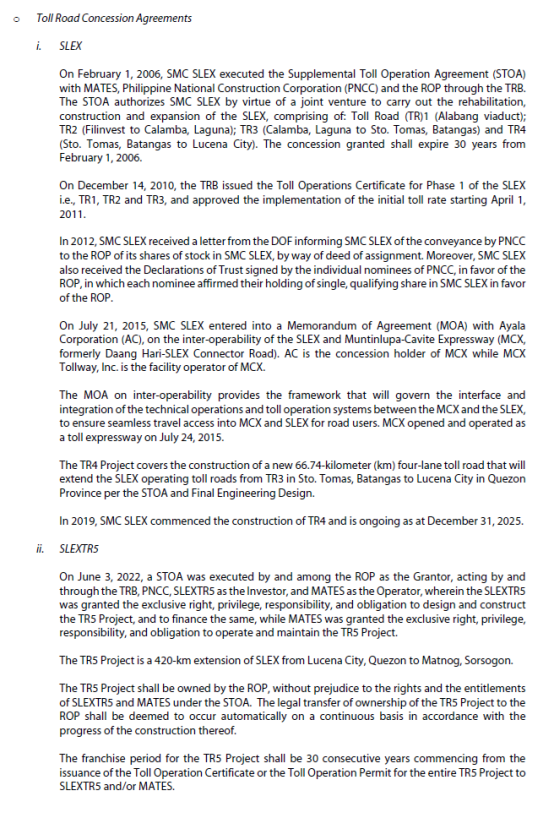

On February 1, 2006, SLTC executed the Supplemental Toll Operation Agreement (STOA) with MATES, PNCC and the ROP through the Toll Regulatory Board (TRB). The STOA authorizes SLTC by virtue of a joint venture to carry out the rehabilitation, construction and expansion of the SLEX, comprising of: Toll Road (TR)1 (Alabang viaduct), TR2 (Filinvest to Calamba, Laguna), TR3 (Calamba, Laguna to Sto. Tomas, Batangas) and TR4 (Sto. Tomas, Batangas to Lucena City). The concession granted shall expire 30 years from February 1, 2006.

On December 14, 2010, the TRB issued the Toll Operations Certificate for Phase 1 of the SLEX i.e., TR1, TR2 and TR3, and approved the implementation of SLTC’s initial toll rate for the said Phase 1. The initial toll rate had been implemented on a staggered basis from January to March 2011, with full implementation starting April 1, 2011.

In 2012, SLTC received a letter from the Department of Finance informing SLTC of the conveyance by PNCC to the ROP of its shares of stock in SLTC, by way of deed of assignment. Moreover, SLTC also received the Declarations of Trust signed by the individual nominees of PNCC, in favor of the ROP, in which each nominee affirmed their holding of single, qualifying share in SLTC in favor of the ROP.

SLTC entered into a MOA on the Interoperability of the Muntinlupa-Cavite Expressway (MCX) (formerly known as the Daang Hari-SLEX Connector Road) and the SLEX (MOA on Interoperability) and an accompanying Addendum to the MOA on Interoperability, both on July 21, 2015, with Ayala Corporation (AC). AC is the concession holder of MCX while MCX Tollway, Inc. is the facility operator of MCX.

The MOA on Interoperability and the addendum provide the framework that will govern the interface and integration of the technical operations and toll operation systems between the MCX and the SLEX, to ensure seamless travel access into MCX and SLEX for road users. MCX opened and operated as a toll expressway beginning July 24, 2015.

ii.NAIA Expressway

On July 8, 2013, Vertex entered into a Concession Agreement with the ROP, through the Department of Public Works and Highways (DPWH), for a 30-year concession period subject to extensions, as may be provided for under the Concession Agreement. Vertex has been granted the right to finance, design, construct, and operate and maintain the NAIA Expressway Project. The NAIA Expressway Project links the three NAIA terminals to the Skyway, the Manila-Cavite Toll Expressway and the Entertainment City of the Philippine Amusement and Gaming Corporation.

On September 22, 2016, Vertex started commercial operations of NAIA Expressway upon receipt of the Toll Operations Permit from the TRB.

The salient features of the Concession Agreement are presented below:

  1. Vertex shall at all times during the concession period maintain a leverage ratio not exceeding 80%.
  2. Vertex shall post a Performance Security for Construction and operations and maintenance in favor of the ROP as guarantee for faithful performance to develop the NAIA Expressway Project. The Performance Security for Construction shall be reduced on the date of expiry of the At-Grade Works and Phase II(a) Defects Liability Period to the amounts as specified in the Concession Agreement.

Throughout the construction period, the DPWH and the TRB shall be allowed to monitor, inspect and check progress and quality of the activities and works undertaken by Vertex to ensure compliance with the Concession Agreement’s Minimum Performance Standards and Specifications, Detailed Engineering Design (DED) or At-Grade Works DED. Vertex shall directly pay for the cost of the Project Overhead Expenses incurred by the DPWH or the TRB until the end of the construction period. The liability of Vertex for the project overhead expenses due to the TRB and DPWH shall not exceed P25 and P50, respectively.

  1. If by the Completion Deadline, the Independent Consultant has not issued written notice that all conditions in the Concession Agreement in relation to the At-Grade Works, Phase II(a) and Phase II(b) have been fulfilled, Vertex shall be liable to the DPWH for the payment of liquidated damages in the amount of P0.15, P1.5 and P2 for every day of delay beyond the At-Grade Works, Phase II(a) and Phase II(b) Construction Completion Deadline, respectively.
  2. The toll revenues collected from the operations of the NAIA Expressway Project are the property of Vertex. Vertex has the right to assign or to enter into such agreements with regard to the toll revenues and their collection, custody, security and safekeeping.
  3. The equity structure of Vertex shall comply with the equity requirements set out in the Concession Agreement. During the lock-up period, which is from the signing date until the end of the third year of the operation period, Vertex shall not register or otherwise permit any transfer of its equity or any rights in relation to its equity except: (a) if after the transfer, (i) the Qualifying Initial Stockholders continue to meet its Equity Requirement; (ii) the Initial Shareholders collectively continue to meet its Equity Requirements, and in each case any new shareholder is approved by the DPWH such consent not to be unreasonably withheld; (b) with the DPWH’s prior written consent; (c) by way of the grant of a Permitted Security Interest or the exercise of rights under a Permitted Security Interest; or such transfer is necessary to comply with any applicable foreign ownership restrictions and the transferee and the terms of the transfer are both approved by the DPWH.
  4. At the end of the concession period, Vertex shall turnover to the DPWH the NAIA Expressway in the condition required for turnover as described in the Minimum Performance Standards Specifications of the Concession Agreement.

iii. Skyway

On June 10, 1994, PNCC, the franchise holder for the construction, operations and maintenance of the Metro Manila Expressway, including any and all extensions, linkages or stretches thereof, such as the proposed Skyway, and PT Citra Lamtoro Gung Persada (CLGP), as joint proponents, submitted to the ROP through the TRB, the Joint Investment Proposal covering the proposed Skyway and the planned Metro Manila Tollways. The Joint Investment Proposal embodied, among others, that CLGP in cooperation with PNCC committed itself to finance, design and construct the Skyway in three stages, consisting of: (a) South Metro Manila Skyway (SMMS) as Stages 1 and 2; (b) North Metro Manila Skyway and the Central Metro Manila Skyway as Stage 3; and (c) Metro Manila Tollways as Stage 4. The Joint Investment Proposal was approved by the TRB on November 27, 1995.

  • Skyway Stages 1 and 2

The STOA for SMMS was executed on November 27, 1995 by and among CMMTC, PNCC and the ROP acting through the TRB. Under the STOA, the design and the construction of the SMMS and the financing thereof, shall be the primary and exclusive privilege, responsibility and obligation of CMMTC as investor. On the other hand, the operations and maintenance of the SMMS shall be the primary and exclusive privilege, responsibility and obligation of PNCC, through its wholly owned subsidiary, the PNCC Skyway Corporation (PSC).

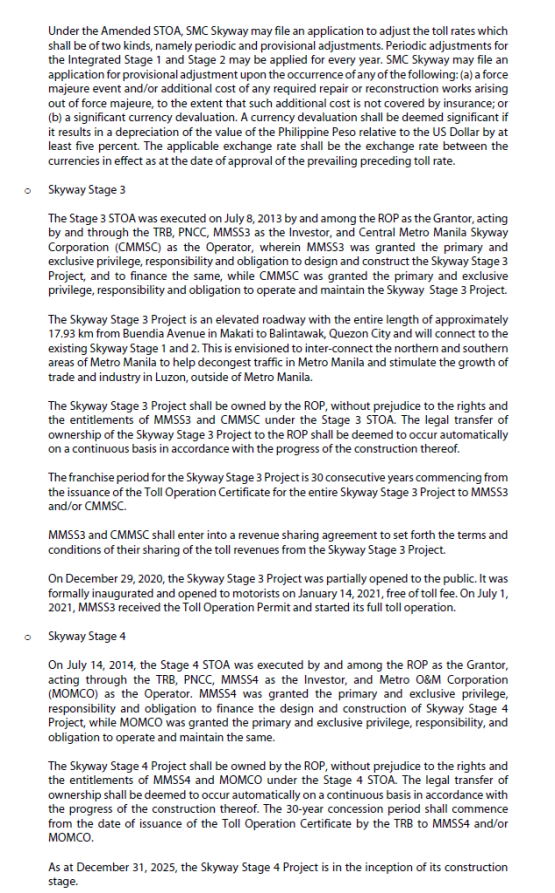

On July 18, 2007, the STOA was amended, to cover among others, the implementation of Stage 2 of the SMMS (Stage 2); the functional and financial integration of Stage 1 of the SMMS (Stage 1) and Stage 2 upon the completion of the construction of Stage 2; and the grant of right to CMMTC to nominate to the TRB a qualified party to perform the operations and maintenance of the SMMS to replace PSC. CMMTC, PNCC and PSC then entered into a MOA for the successful and seamless turnover of the operations and maintenance responsibilities for the SMMS from PSC to SOMCO.

The SMMS shall be owned by the ROP, without prejudice to the rights and entitlement of CMMTC and SOMCO under the STOA. The legal transfer of ownership of the SMMS to the ROP shall be deemed to occur automatically on a continuous basis in accordance with the progress of construction. The toll revenues are shared or distributed among PNCC, CMMTC and SOMCO for the operations and maintenance of the SMMS.

The 30-year franchise period for the Integrated Stage 1 and Stage 2 commenced on April 25, 2011.

Under the STOA, CMMTC may file an application to adjust the toll rates which shall be of two kinds, namely periodic and provisional adjustments. Periodic adjustments for the Integrated Stage 1 and Stage 2 may be applied for every year. CMMTC may file an application for provisional adjustment upon the occurrence of a force majeure event or significant currency devaluation. A currency devaluation shall be deemed significant if it results in a depreciation of the value of the Philippine peso relative to the US dollar by at least 5%. The applicable exchange rate shall be the exchange rate between the currencies in effect as of the date of approval of the prevailing preceding toll rate.

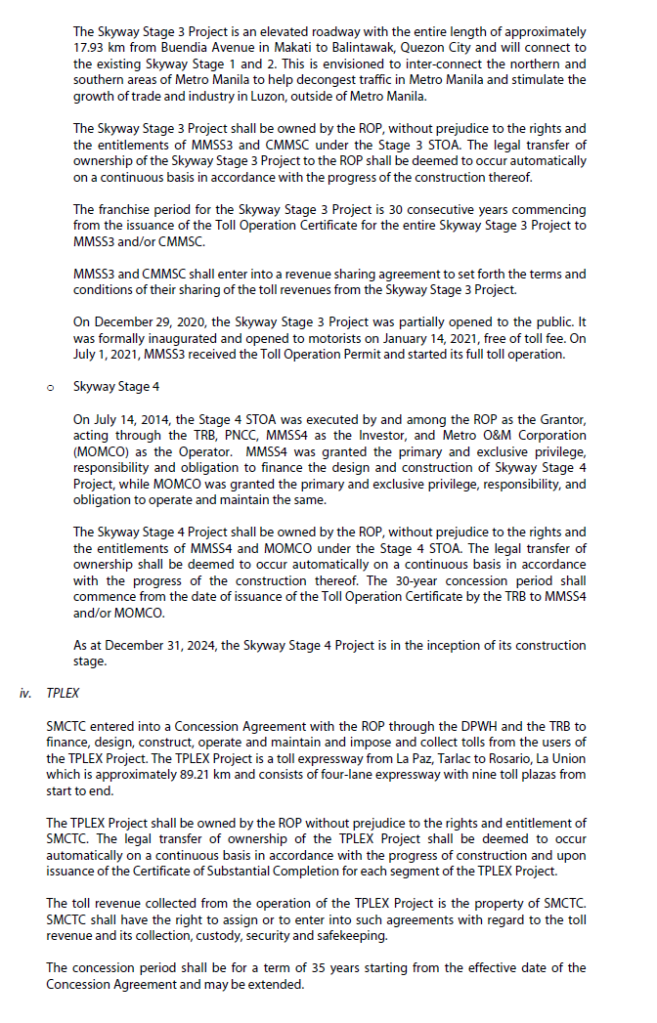

  • Skyway Stage 3

The Stage 3 STOA was executed on July 8, 2013 by and among the ROP as the Grantor, acting by and through the TRB, PNCC, CCEC as the Investor, and Central Metro Manila Skyway Corporation (CMMSC) as the Operator, wherein CCEC was granted the primary and exclusive privilege, responsibility, and obligation to design and construct the Skyway Stage 3 Project, and to finance the same, while CMMSC was granted the primary and exclusive privilege, responsibility, and obligation to operate and maintain the Skyway Stage 3 Project.

The Skyway Stage 3 Project is an elevated roadway with the entire length of approximately 14.82 km from Buendia Avenue in Makati to Balintawak, Quezon City and will connect to the existing Skyway Stage 1 and 2. This is envisioned to inter-connect the northern and southern areas of Metro Manila to help decongest traffic in Metro Manila and stimulate the growth of trade and industry in Luzon, outside of Metro Manila.

The Skyway Stage 3 Project shall be owned by the ROP, without prejudice to the rights and the entitlements of CCEC and CMMSC under the Stage 3 STOA. The legal transfer of ownership of the Skyway Stage 3 Project to the ROP shall be deemed to occur automatically on a continuous basis in accordance with the progress of the construction thereof.

The franchise period for the Skyway Stage 3 Project is 30 consecutive years commencing from the issuance of the Toll Operation Certificate (TOC) for the entire Skyway Stage 3 Project to CCEC and/or the CMMSC.

As of December 31, 2017, CCEC is in the construction stage of the Skyway Stage 3 Project.

CCEC and CMMSC shall enter into a revenue sharing agreement to set forth the terms and conditions of their sharing of the toll revenues from the Skyway Stage 3 Project.

  • Skyway Stage 4

The Stage 4 STOA was executed on July 14, 2014 by and among the ROP as the Grantor, acting through the TRB and PNCC, CITI as the Investor, and Metro O&M Corporation (MOMCO) as the Operator, wherein CITI was granted the primary and exclusive privilege, responsibility, and obligation to finance the design and construction of Skyway Stage 4 Project, while MOMCO was granted the primary and exclusive privilege, responsibility and obligation to operate and maintain the same.

The Skyway Stage 4 Project serves as another expressway system that aims to further decongest EDSA, C5 and other major arteries of the Metropolis. Further, it aims to provide faster alternate route and accessibility to the motorist when travelling from the province of Rizal and Calabarzon area to Metropolis.

The Skyway Stage 4 Project shall be owned by the ROP, without prejudice to the rights and the entitlements of CITI and MOMCO under the Stage 4 STOA. The legal transfer of ownership shall be deemed to occur automatically on a continuous basis in accordance with the progress of the construction thereof. The 30-year concession period shall commence from the date of issuance of the TOC by the TRB to CITI and/or MOMCO.

As at December 31, 2017, CITI is in the preparatory stage of the Skyway Stage 4 Project.

CITI and MOMCO shall enter into a revenue sharing agreement to set forth the terms and conditions of their sharing of the toll revenues from the Skyway Stage 4 Project.

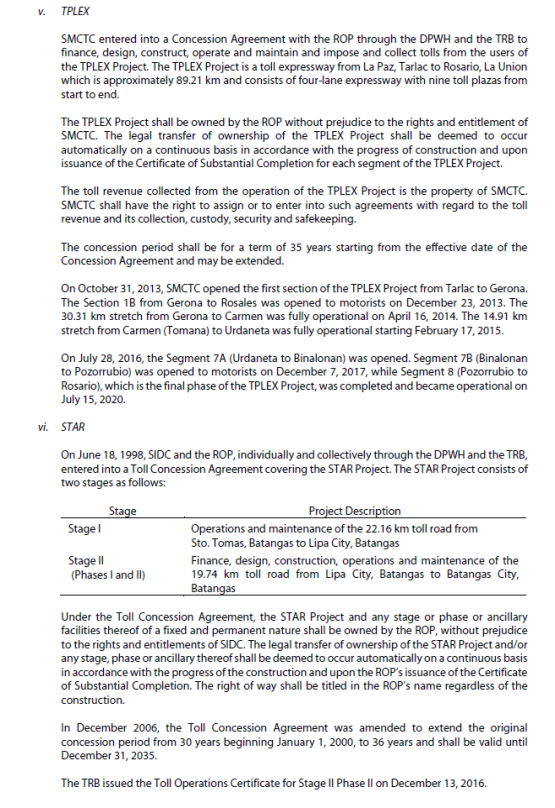

iv. TPLEX

PIDC entered into a Concession Agreement with the ROP through the DPWH and the TRB to finance, design, construct, operate and maintain and impose and collect tolls from the users of the TPLEX Project. The TPLEX Project is a toll expressway from La Paz, Tarlac to Rosario, La Union which is approximately 88.85 kilometers and consists of four-lane expressway with nine toll plazas from start to end.

The TPLEX Project shall be owned by the ROP without prejudice to the rights and entitlement of PIDC. The legal transfer of ownership of the TPLEX Project shall be deemed to occur automatically on a continuous basis in accordance with the progress of construction and upon issuance of the Certificate of Substantial Completion for each section of the TPLEX Project.

The toll revenue collected from the operation of the TPLEX Project is the property of PIDC. PIDC shall have the right to assign or to enter into such agreements with regard to the toll revenue and its collection, custody, security and safekeeping.

The concession period shall be for a term of 35 years starting from the effective date of the Concession Agreement and may be extended.

On October 31, 2013, PIDC opened the first section of the TPLEX Project from Tarlac to Gerona. The Section 1B from Gerona to Rosales was opened to motorists on December 23, 2013. The 32.56-km stretch from Gerona to Carmen was fully operational on April 16, 2014. The 12.66-km stretch from Carmen (Tomana) to Urdaneta was fully operational starting March 17, 2015.

On July 28, 2016, the Segment 7A (Urdaneta to Binalonan) was opened. Segment 7B (Binalonan to Pozorrubio) was opened to motorists on December 6, 2017, while Segment 8 (Pozorrubio to Rosario) is expected to be completed in March 2019.

v. STAR

On June 18, 1998, SIDC and the ROP, individually and collectively through the DPWH and the TRB, entered into a Concession Agreement covering the STAR Project.

Under the Concession Agreement, the following are the activities related to the components of the STAR Project:

  1. The preliminary and final engineering design, financing and construction of Stage II of the STAR Project.
  2. The design and construction of all ancillary toll road facilities, toll plazas, interchanges and related access facilities of Stage I of the STAR Project, an ROP-constructed toll road, and for Stage II of the STAR Project road to be constructed by SIDC.
  3. The operation and maintenance of the STAR Project as toll road facilities within the concession period of 30 years from January 1, 2000 up to December 31, 2029.

In December 2006, the Concession Agreement was amended extending the concession period for an additional six years, to compensate for the delay in the commencement of the construction of the Stage II, Phase II of the STAR Project. Accordingly, the concession period is until December 31, 2035.

The STAR Project and any stage or phase or ancillary facilities thereof of a fixed and permanent nature shall be owned by the ROP, without prejudice to the rights and entitlements of SIDC. The legal transfer of ownership of the STAR Project and/or any stage, phase or ancillary thereof shall be deemed to occur automatically on a continuous basis in accordance with the progress of the construction and upon the ROP’s issuance of the Certificate of Substantial Completion. The right of way shall be titled in the ROP’s name regardless of the construction.

The STAR Project consists of two stages as follows:

Stage I Operations and maintenance of the 22.16-km toll road from Sto. Tomas, Batangas to Lipa City, Batangas

Stage II Finance, design, construction, operations and maintenance of the 19.74-km toll road from Lipa City, Batangas to Batangas City, Batangas

SIDC started its commercial operations on August 1, 2001 after the issuance by the TRB to SIDC of the TOC for the operations and maintenance of the Stage I of the STAR Project on July 31, 2001.

The TRB issued to SIDC the TOC for the operations and maintenance of the Stage II, Phase I of the STAR Project on April 16, 2008. SIDC started the construction of the remaining portion of Stage II in 2013 and was completed in October 17, 2014.

The TRB issued an Amended TOC for the STAR Project, including Stage II, Phase II on December 13, 2016. The Amended TOC supersedes all previously issued TOCs and is to be reckoned effective as of April 17, 2008.

  • Port Concession Agreements

On November 19, 2009, MNHPI entered into a Contract for the Development, Operation and Maintenance of the Manila North Harbor (the Contract) with the PPA, a government agency. Under the Contract, the PPA grants MNHPI the sole and exclusive right to manage, operate, develop and maintain the Manila North Harbor for 25 years reckoning on the first day of the commencement of operations renewable for another 25 years under such terms and conditions as the parties may agree. In consideration, MNHPI shall remit a fixed fee every quarter and submit a performance security to the PPA.

In this regard, MNHPI shall provide services and development based on the operation and volume requirement of the port and shall be allowed to collect fees and charges, as approved by the PPA. The fees to be charged by MNHPI shall be in accordance with the price policy and rate setting mechanism adopted by the PPA and the laws and regulations promulgated by the ROP. Upon the expiration of the Contract or in the event of its termination or cancellation prior to its expiration, all existing improvements, structures, building and facilities at the Manila North Harbor, permanent or semi-permanent, constructed by or belonging to MNHPI shall automatically become the property of the PPA without any obligation to reimburse therefore, except for port equipment purchased five years prior to expiration or termination of the Contract wherein the PPA has option to either purchase or lease the same from MNHPI.

On April 12, 2010, the PPA turned over the operations of the Manila North Harbor to MNHPI. MNHPI recognized as concession assets all costs directly related to the Contract and development of the port.

On March 21, 2011, MNHPI and the PPA entered into a Clarificatory Agreement to the Contract related to the implementation of some terms and conditions to harmonize and be consistent with the date of the turnover, which was on April 12, 2010, and ensure fairness to both parties concerned as follows: (a) the fixed fee is exclusive of VAT; (b) the performance security shall be equivalent to 60% of the annual fixed fee, which shall be reckoned from April 12, 2010; (c) establishment of the Port Worker’s Retirement and Separation Fund shall be within one year from April 12, 2010; (d) all rentals within the area of management, operation, development and maintenance of MNHPI from April 12, 2010 and thereafter shall accrue to MNHPI; and (e) applicable terms and conditions of the Contract shall become operative on April 12, 2010.

  • Water Concession Agreements

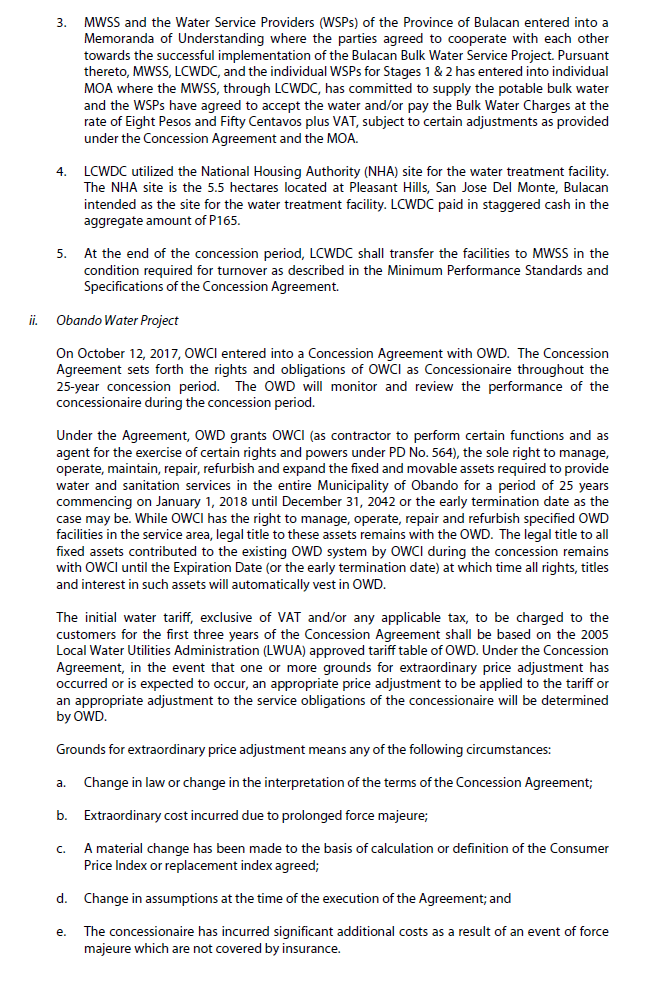

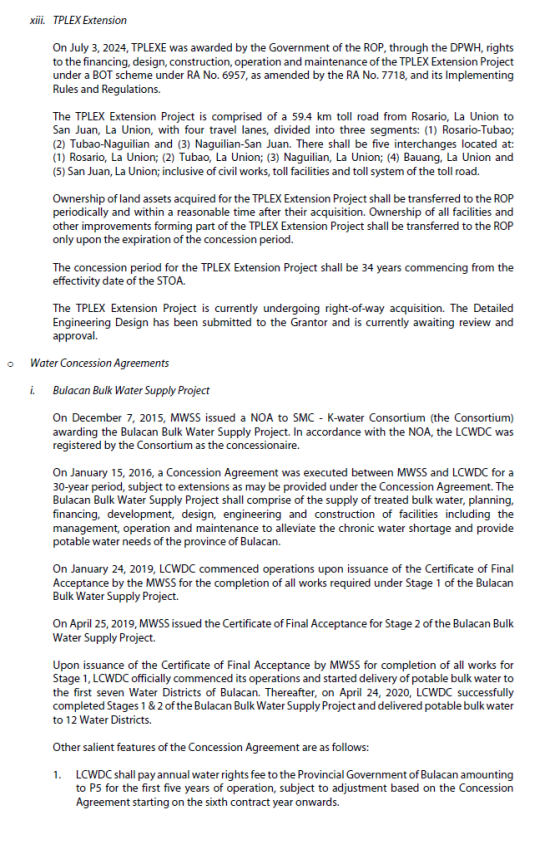

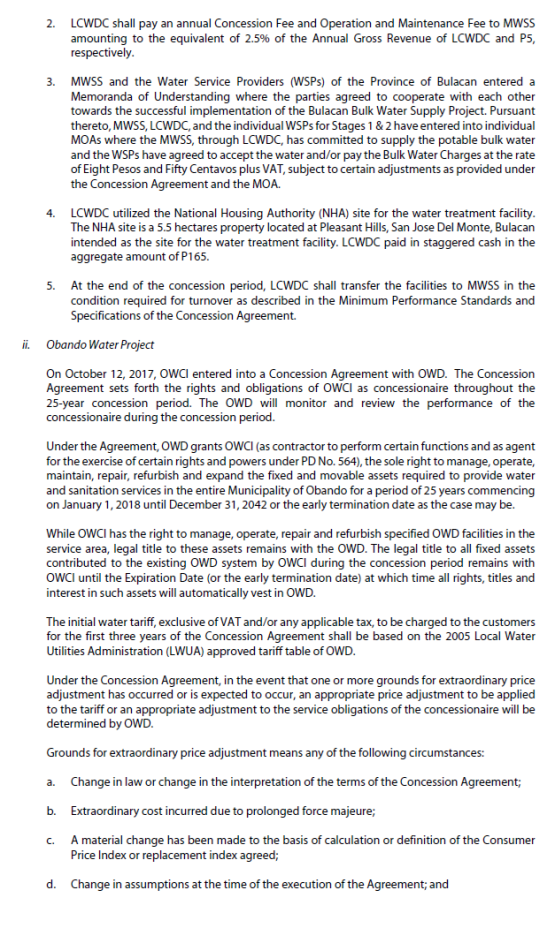

On December 7, 2015, MWSS issued a NOA to SMC – K-water Consortium (the Consortium) awarding the Bulacan Bulk Water Supply Project. In accordance with the NOA, the LCWDC was registered by the Consortium as the concessionaire.

On January 15, 2016, a Concession Agreement was executed between MWSS and LCWDC for a 30-year period, subject to extensions as may be provided for under the Concession Agreement.

The salient features of the Concession Agreement are presented below:

  1. L CWDC shall pay an annual concession fee to MWSS equivalent to 2.5% of Bulacan Bulk Water Supply Project’s annual gross revenue.
  2. LCWDC shall pay water right fee to the Provincial Government of Bulacan, as follows:
  • P5 as annual revenue share for the first five years of operations;
  • 0.5% of the Bulacan Bulk Water Supply Project’s annual gross revenue starting from the sixth year until the 15th year of operation; and
  • 1.0% of the Bulacan Bulk Water Supply Project’s annual gross revenue starting from the 16th year of operation until the transfer date.
  1. The Bulacan Bulk Water Supply Project will be implemented in three stages in different localities around the Province of Bulacan. The Water Service Providers (WSPs) entered into separate Memoranda of Understanding (MOU) with MWSS pursuant to which they agreed to cooperate with each other towards the successful implementation of the Bulacan Bulk Water Supply Project. Furthermore, each MOU also provides that MWSS, respective WSP, and LCWDC will enter into a MOA simultaneous with the execution of the Concession Agreement.
  2. LCWDC can use the National Housing Authority (NHA) site for the water treatment facility. NHA site is the 5.5 hectares located at Pleasant Hills, San Jose Del Monte, Bulacan intended as the site for the water treatment facility. LCWDC can either pay in staggered cash or in installment. Ownership of NHA site shall be and shall remain with MWSS at all times.

LCWDC may also opt to acquire an alternative site, including all land rights, and rights of way (whether permanent or temporary) required and otherwise necessary to access the alternative site and carry out the works for the water treatment facility. Ownership of alternative site, land rights and right of way required shall be with LCWDC and shall continue to be so until transfer date.

  1. At the end of the concession period, LCWDC shall transfer the facilities to MWSS in the condition required for turnover as described in the Minimum Performance Standards and Specifications of the Concession Agreement.
